Our Project's Milestones
Here are the actual deliverables we achieved in order to iterate our project towards completion.
Testable Hypothesis
When users rely on this device, reminders remove the burden of constant memorization, and the incentive system reframes taking medication as something rewarding rather than tedious — ultimately measurably improving medication adherence rates among users.

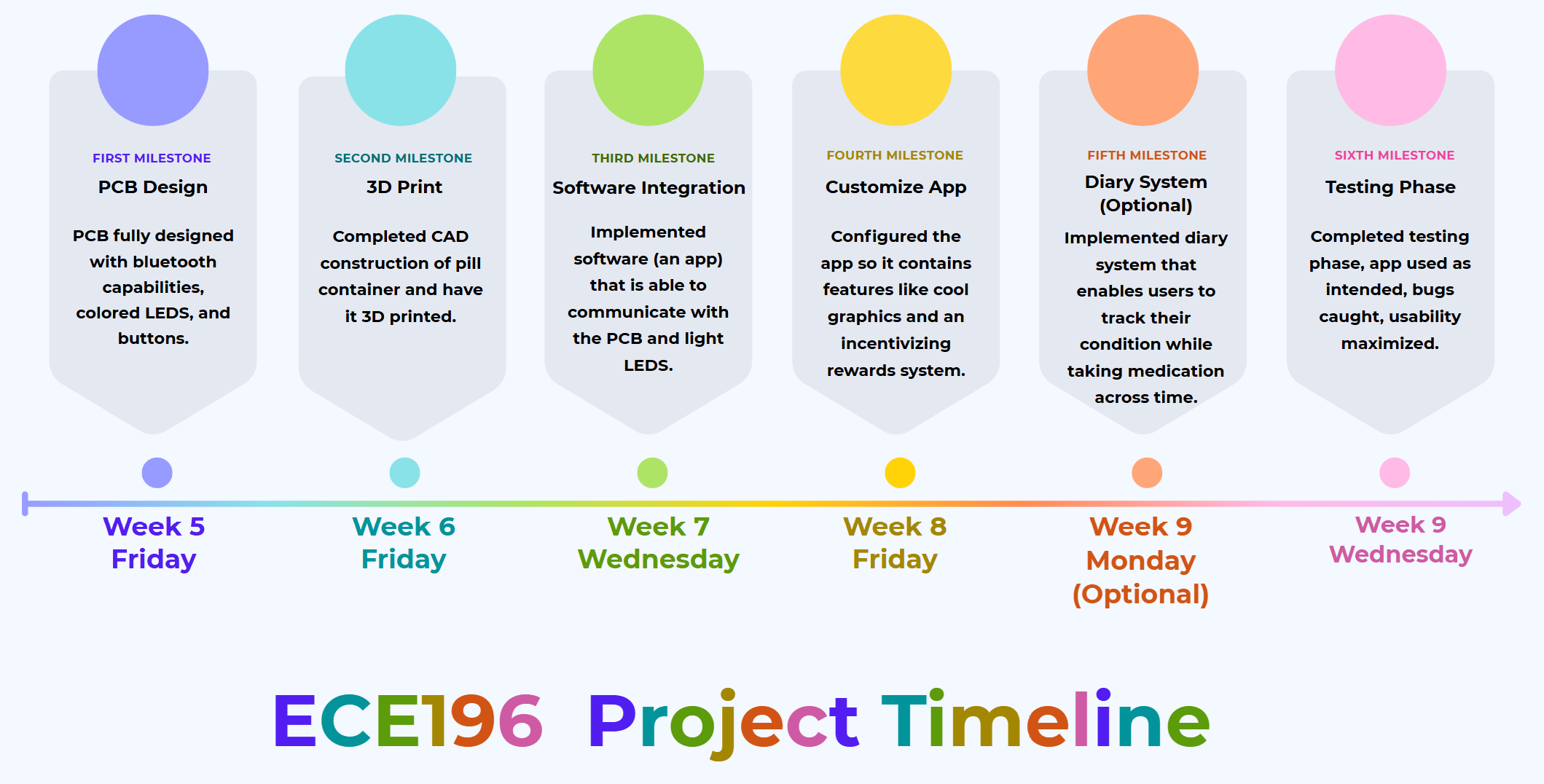

Our Original Timeline
What completion looks like.
-
Wk 5 · FriMilestone 01 Completed on Time

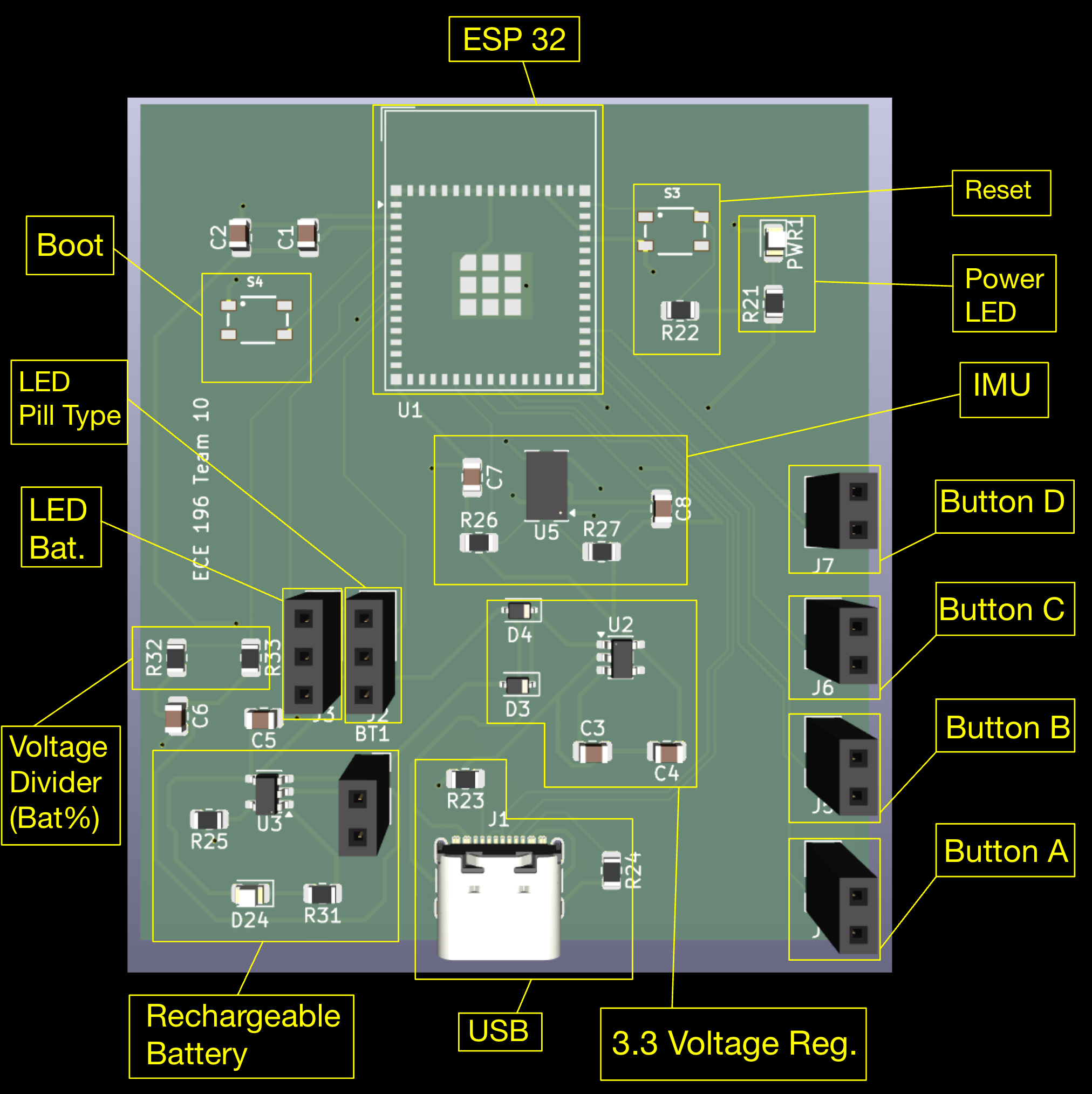

PCB Fully Designed
Our PCB was fully designed and ordered, implementing all the intended features: Bluetooth capability, through-holes for connecting to external LEDs and buttons, an IMU module, and rechargeability for the battery. No significant issues or pivots.
Milestone 01 · PCB & connectivity -
Wk 6 · FriMilestone 02 Completed on Time
BLE Communication Completed
iOS to ESP32 BLE communication was fully implemented (LightBlue/Arduino Sketch) and our phone was able to successfully read button presses from our DevBoard and light LEDs connected to our DevBoard over BLE. Implementing this was actually slightly easier than expected.
Wk 7 · FriMilestone 03 Completed with Small DelayBare iOS App Completed
We were able to implement and run a very basic app on our iPhone. Our previously designed BLE communication was scaffolded to be compatible with our app, allowing our app to communicate over BLE to control our DevBoard — limited to only lighting and adjusting LEDs and registering button presses. This milestone experienced slight delays due to issues debugging Swift code and setting up Xcode.
Wk 9 · MonMilestone 04 Completed with Small DelayApp Scheduling and Incentivization Implemented

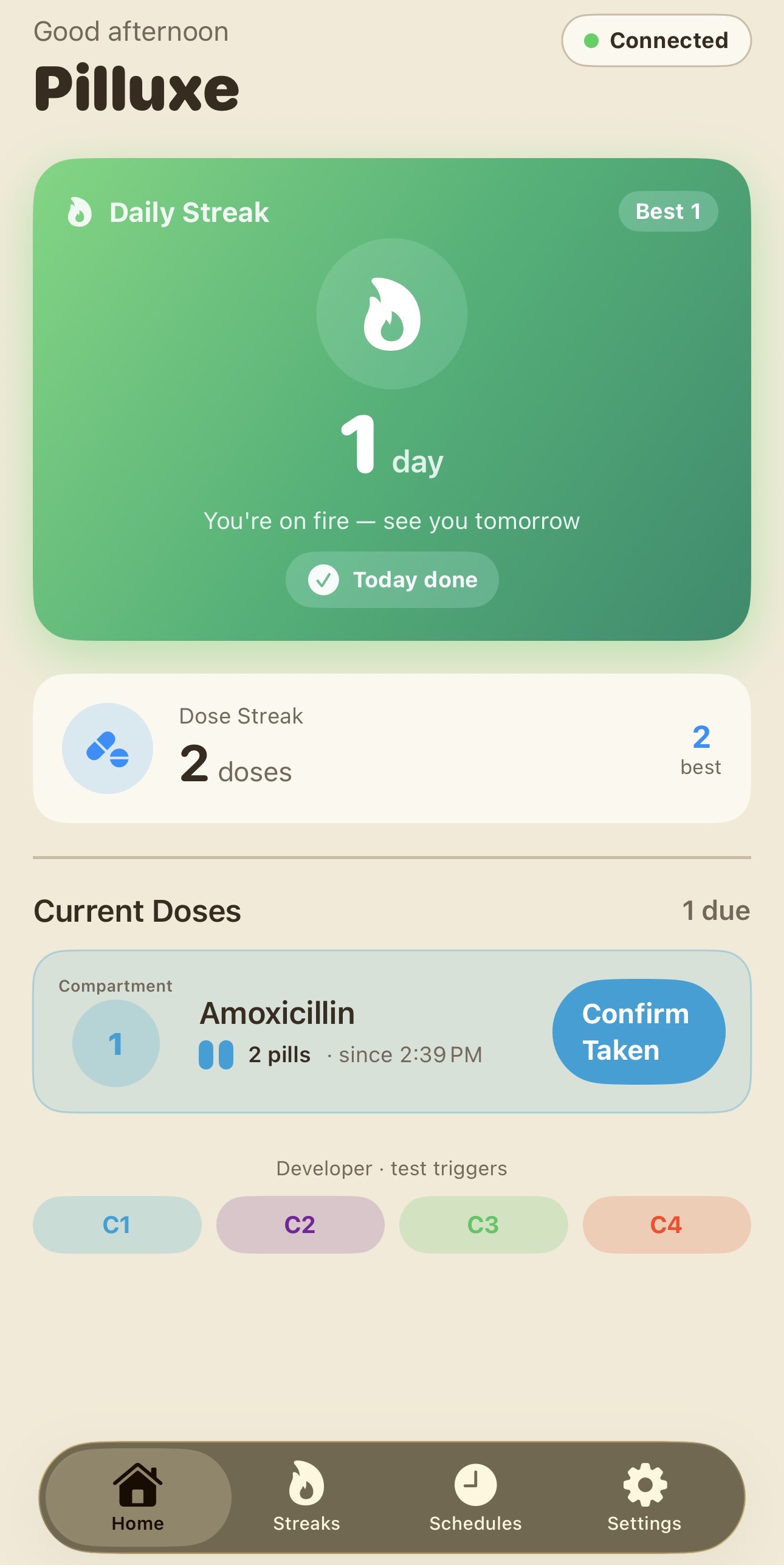

Our app's final intended features were successfully implemented: users can set schedules and receive reminders, dose and daily streaks act as adherence incentivization, and users are able to customize their box LEDs as well as the app visuals. All app controls work on pillbox hardware.

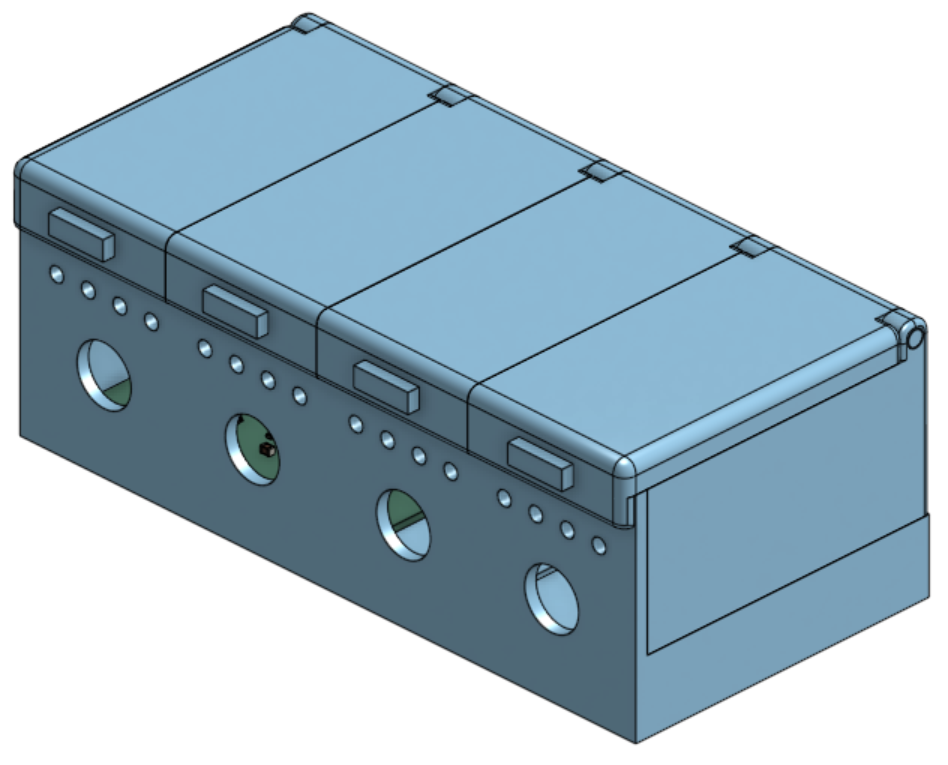

Milestone 04 · Full app implementation Wk 9 · WedMilestone 05 Completed with HUGE DelaySmart Pillbox Designed and 3D-Printed
While developing and iterating on our 3D-print, we experienced many issues. Measurements were off, the filament didn't print precisely, and we printers were unavailable. This pushed our final 3D print back significantly, though we still managed to finish it.
Milestone 05 · Finished CAD Wk 9 · FriFinal milestone FinalTesting and evaluation phase completed.
Real-world testing of the app and pillbox to identify flaws and evaluate whether the system actually reduces tedium and feels enjoyable to use.
Milestone 05 · Testing finished. Challenges we've faced When the plan met reality.
While ordering parts, we misordered a dioide and this delayed the time for us to begin testing our real PCB. We also burnt our MCP by creating a short between our battery terminals, luckily we were able to fix this by replacing it with a spare.
These setbacks taught us to be meticulous, every small mistake had large implications on the timing of our project. We also didn't need to pivot away from our original design, our final design matched exactly what we had envisioned at the beginning.
